Apple cabins

Apple cabin pods for resort and hotel projects.

Apple cabins are factory-finished modular guest rooms for resorts, holiday parks and nature stays. This page compares D1, D2 and F2 by room plan, footprint, freight method, local work and the information a developer needs before requesting a price.

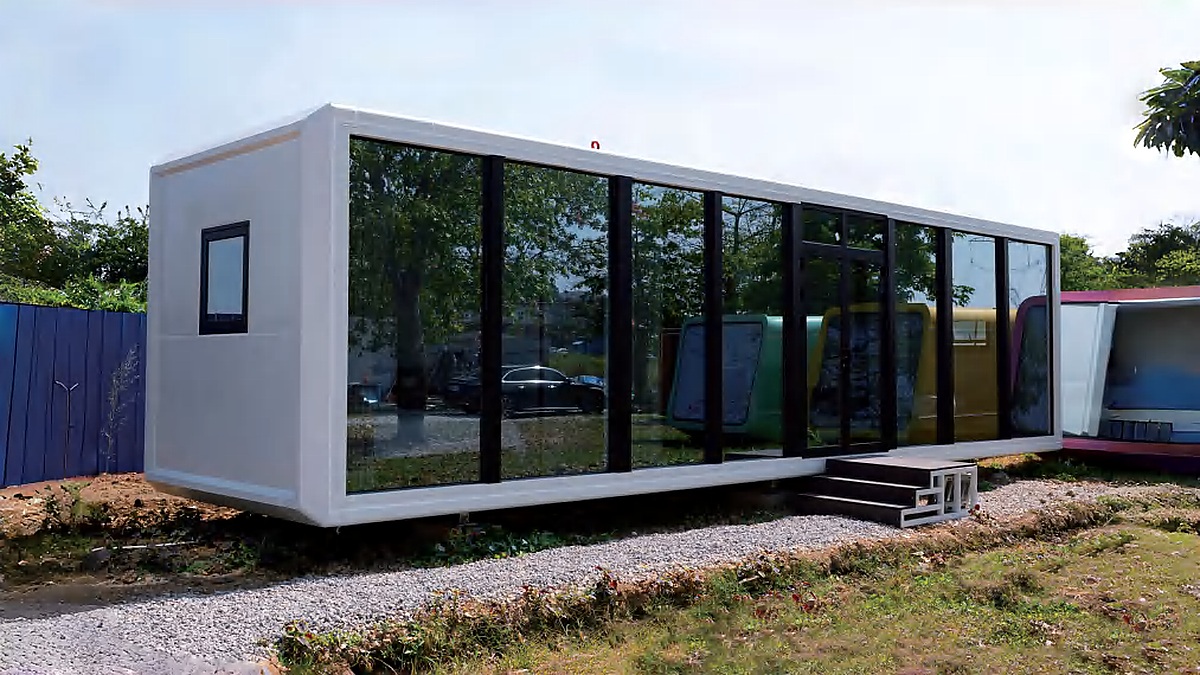

Finished white apple cabin with full-height glazing and exterior entry steps
Finished apple cabin · product reference

Start with the project

Decide what matters first.

A useful review begins with your site and operating needs, then narrows the product and configuration.

Start with use

Define occupancy, operating pattern, destination and the outcome the building must support.

Compare the form

Review footprint, layout, transport form and the configuration that should be priced.

Plan the site

Assign access, supports, lifting, utilities, approvals and final installation work.

In plain terms

An apple cabin — also searched as an apple cabin pod or apple cabin house — is a prefabricated accommodation unit with a rounded-corner shell and a glazed elevation. The structure, enclosure, services and interior package are completed in the factory, then the cabin is lifted onto prepared supports and connected on site. Because most versions travel as a finished volume, transport dimensions can influence delivered cost more than floor area does.

Model references

Compare size and capacity.

Dimensions shown are current product references. Confirm transport dimensions, the selected layout and final drawing for your order.

D1 11.5 × 3.3 × 3.2 mApprox. 38 m²
D2 11.5 × 4.4 × 2.45 mApprox. 52 m²
F2 Two 11.5 × 2.2 × 2.45 m modulesApprox. 52 m² total

Developer selection

Choose the room key before the exterior finish.

D1, D2 and F2 are not three cosmetic versions of the same apple cabin. They create different guest products and different freight plans. Use this first-pass comparison to form the room schedule; the approved drawing remains the order document.

ModelRoom conceptFloor areaDelivery formPlanning role
D1One-bedroom resort cabinApprox. 38 m²Finished out-of-gauge volumeCouples' suite, rental cabin or premium view-facing key
D2Wider cabin with private balconyApprox. 52 m²Finished out-of-gauge volumeLonger-stay suite or a room needing more living width
F2Three-bedroom duplex suiteApprox. 52 m² totalTwo modules; each loads in a 40 HCFamily inventory or sites where standard-container logistics matter

Guest capacity depends on the approved furniture and room plan. Confirm bed count, bathroom layout, kitchen scope, storage, housekeeping access and accessibility requirements before the model is frozen.

Download the Apple cabin model decision sheet

Freight consequence

Not every footprint fits a container.

A 40 HC door opening measures 2.34 m wide and 2.58 m high. Published section dimensions decide the freight method before a price exists.

FormatSectionShips asWhy
D13.30 × 3.20 mOut of gaugeOver door width and height. Moves as breakbulk or on a flat rack.
D24.40 × 2.45 mOut of gaugeOver door width. Moves as breakbulk or on a flat rack.
F22.20 × 2.45 m, ×22 × 40 HCEach module loads inside a standard container.

Section is width × height. Out-of-gauge movements are quoted route by route and can change the delivered cost materially. Final loading is confirmed against the approved drawing.

How container fit is calculated

Product references

Review exterior, interior and setup.

Use each image to discuss a specific part of the configuration and delivery plan.

Apple cabin installed at an accommodation site
Installed product reference

Review external access, deck interfaces, privacy and the relationship between the cabin and its site.

Finished apple cabin bedroom and living interior
Finished interior reference

Confirm furniture, wall finish, flooring, lighting and window treatments as a coordinated package.

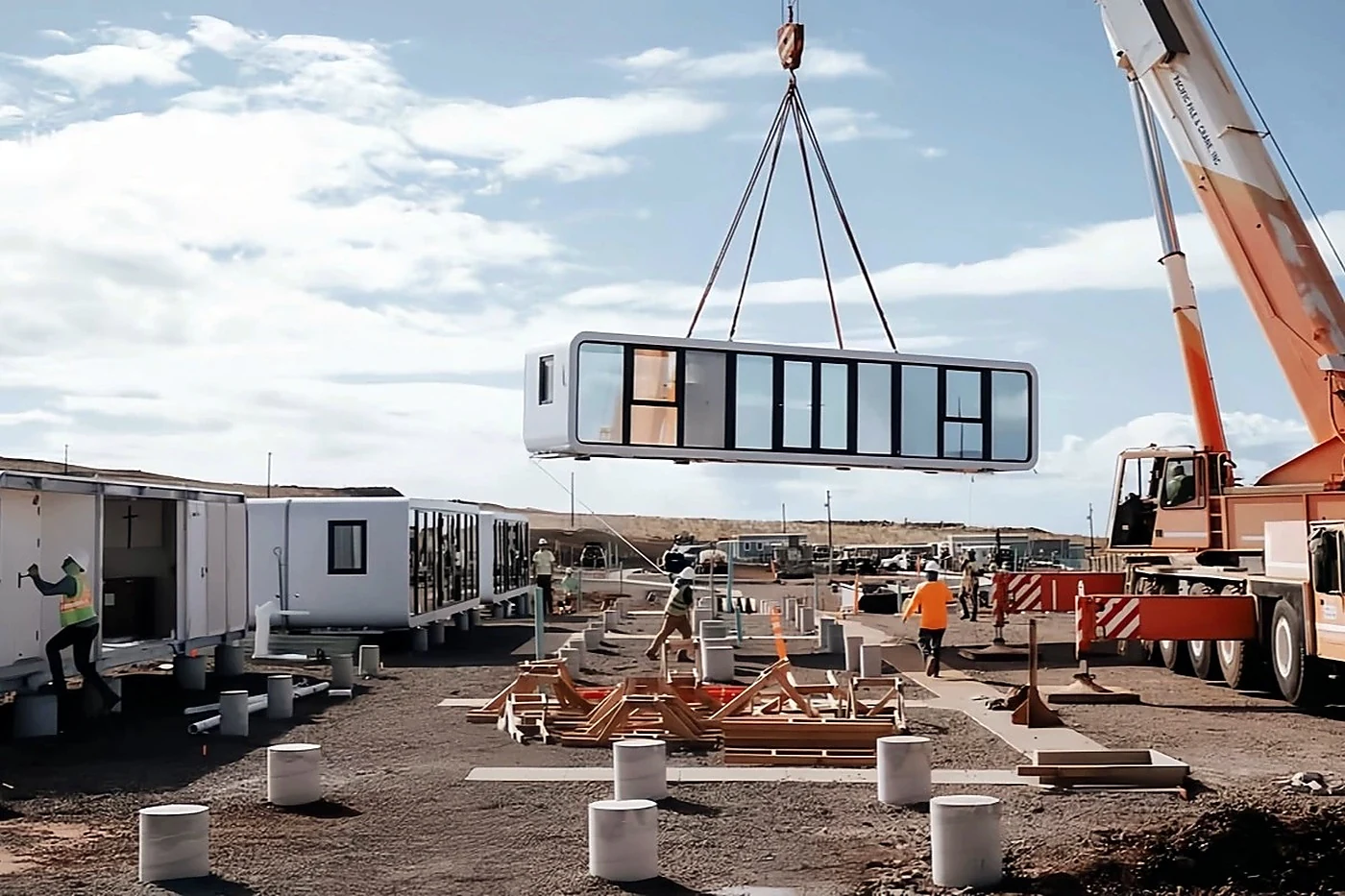

Apple cabin being lifted into position at a project site
Installation reference

Your receiving plan should define access, crane space, temporary storage, supports and local responsibilities.

Configuration review

Confirm the package.

Use the quotation and approved drawings to define the product package and local responsibilities.

Structure

Reference specifications show a galvanized steel frame with an insulated panel enclosure.

Exterior

Aluminum cladding and aluminum-framed door and window systems vary by model and finish package.

Interior

Wall lining, flooring, cabinetry, bathroom and furniture selections are confirmed per project.

Site work

Foundations or supports, lifting, utility connections and approvals are coordinated locally.

Site interfaces

What the cabin supplier and local project team must coordinate.

An apple cabin can leave the factory substantially complete, but it is not a permit-free or site-free product. Close these four interfaces before production release.

Route and crane

Check port limits, turning radii, bridge and overhead restrictions, final-road permits, lifting weight, crane radius and the set-down sequence before the cabin drawing is released.

Foundations and levels

The local engineer confirms soil assumptions, support type, bearing locations, finished levels, drainage and anchorage. The cabin supplier confirms the matching support-point drawing and tolerance.

Water, waste and power

Agree the destination electrical standard, connected load, water inlet, waste outlet, hot-water system, HVAC and the exact connection positions on the approved service drawing.

Approvals and records

The local design professional and authority decide the code path. Request the structural basis, material and component information, drawings, inspection records and installation instructions needed for that review.

Scope boundary

Know who confirms what.

Keep the product package, your project inputs and local site work clear before the order is approved.

AeroPodHomes review

Product-family comparison, configuration options, drawings and order information.

You provide

Use, destination, quantity, layout priorities, site conditions and target timing.

Local team

Approvals, foundations, lifting, utility connections and site installation.

Ordering

What moves the figure.

On an apple cabin the transport format moves the delivered figure more than the floor area does. D1 and D2 exceed a container door opening and travel as out-of-gauge cargo quoted route by route; F2 splits into two container-legal modules. Quantity, destination and the local scope do the rest.

Order quantityConfirmed for the selected format, shipment plan and project phase.
ProgrammeConfirmed after the drawing set, quantity and factory schedule are agreed.
How it is quotedOne figure for the agreed scope, with a written exclusions list issued beside it.
PaymentAmounts, due points and required release records are defined in the quotation and contract.
InspectionYou, or an inspector you appoint, may attend the pre-dispatch inspection or inspect independently, at your cost.
WarrantyPeriods, included elements, exclusions and claim handling are defined in the project contract.

Foundations, crane and lifting, utility connections, installation labour and local permits sit with the buyer; engineering, manufacture, inspection, packing and the document set sit with us.

The full landed-cost stack, factory gate to first guest

Apple cabin RFQ

Eight inputs turn a product enquiry into a project quotation.

Send the same information to every bidder. That makes model, freight, site scope and exclusions comparable instead of hiding them inside one unit price.

  • Project location and nearest receiving port
  • Number of cabins and phase schedule
  • Guests, beds and accessible-room requirement
  • Bathroom, kitchen and furniture brief
  • Destination electrical and plumbing standards
  • Preferred D1, D2 or F2 — or permission to recommend
  • Site access, crane constraints and foundation status
  • Required delivery date and local approval stage
Open the complete prefab cabin RFQ template
Illustrative modular building procurement desk with drawings and evaluation schedules
Procurement illustration · not a project record · route, lift and supports belong in the RFQ

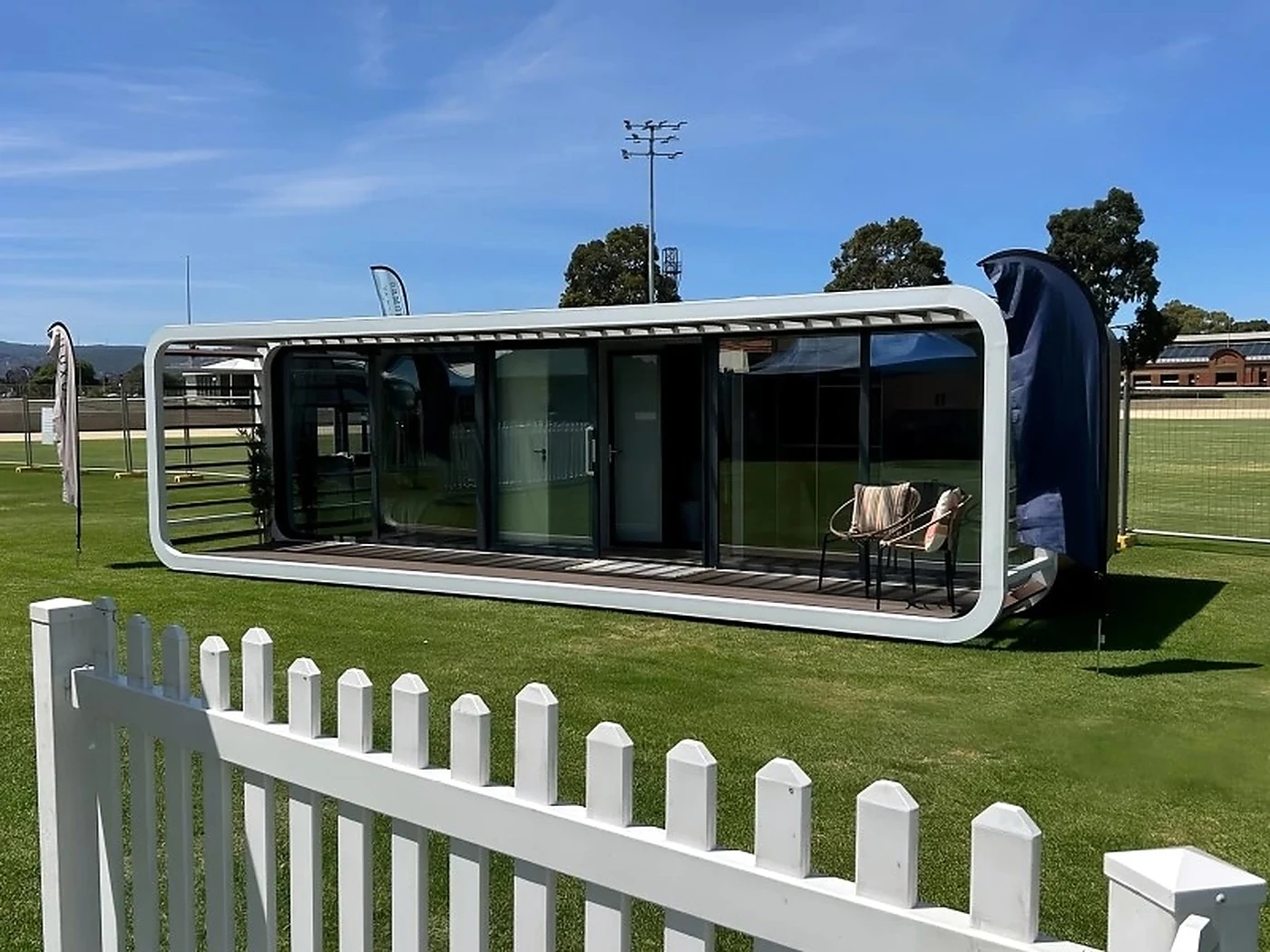

Apple cabin installed at an accommodation site
Installed product reference

Before quotation

Bring the site. Define the right model.

A useful first review connects the building family to your project conditions, rather than treating selection and site planning as separate decisions.

  • Intended use and occupancy
  • Preferred layout and quantity
  • Access and unloading route
  • Foundations or support points
  • Utility connection plan
  • Approved drawings and scope
Common applications
  • Holiday parks
  • Guest suites
  • Eco-tourism sites
  • Staff accommodation

Common questions

Before pricing.

What is an apple cabin?+

A prefabricated cabin with a rounded-corner shell and a glazed long elevation, delivered finished rather than built on site. It is a product format, not a single manufacturer's model.

Are an apple cabin pod and an apple cabin house the same thing?+

Usually, yes. Apple cabin, apple cabin pod and apple cabin house are market names for the same rounded, factory-finished modular format. Compare the actual drawing, structure, insulation, room plan and shipping dimensions rather than relying on the name.

Are apple cabins suitable for resorts and hotels?+

Yes, when the room plan, housekeeping access, thermal and acoustic performance, services, approvals and delivery route are planned as one package. D1 and D2 work as signature finished-volume rooms; the split-module F2 can suit family inventory and standard-container logistics.

Can an apple cabin ship inside a standard container?+

The F2 format can: each of its two modules loads into a 40 HC. D1 and D2 exceed a container door opening and travel as out-of-gauge cargo, which is quoted route by route.

How much does an apple cabin cost?+

We quote one figure for the agreed scope rather than publish a list price, because the delivered cost is decided by the transport format before it is decided by the cabin. D1 and D2 move as out-of-gauge cargo priced route by route; F2 loads into two standard containers. Quantity, destination, duty treatment and the local scope — foundations, crane, utility connections and installation labour — complete the figure, and a written exclusions list is issued with the quotation.

How are order quantity and the factory programme confirmed for apple cabins?+

They are confirmed for the selected model, approved drawing set, quantity, out-of-gauge route and current factory schedule.

Can we inspect an apple cabin before it ships?+

Yes. We inspect against a written plan and issue the report, and you or an inspector you appoint may attend or inspect independently, at your cost. Inspection scope, attendance rights and any payment-release evidence are defined in the quotation and contract.

Which model should we start with?+

Start with occupancy, room layout, destination, transport access and unit quantity. These inputs narrow the appropriate footprint.

Can the interior package be changed?+

Finish and furniture choices can be reviewed, but availability and inclusion must be confirmed in the model quotation.

What should a developer include in an apple cabin RFQ?+

Provide the site, quantity and phases, guest and room brief, destination service standards, access and crane constraints, local approval stage and required delivery date. Ask every supplier to return the same scope, exclusions, shipping method, document schedule, inspection plan and warranty terms.

Go deeper before you brief us

Next step

Start with your site brief.

Share location, use, quantity, access and timing.

Request review
WhatsApp
